Building a Compost Toilet in Fijimaikeli, m@greatempty.us, 7nov04



History



Events back in August:



“Do you want a PCV?” Eileen asks.

YES, they answer.

“Will you take good care of her?” she asks.

‘Her’? (Damn.) Oh…YES, they answer.

“Can she live in the house?” she asks.

YES, they answer.

“But it needs a bathroom, will you build the bathroom?”

YES, it will be ready in 2 weeks, they answer.

“And how will you pay for it?”

Now they look very confused. “Erami said the Provincial Office will pay for it.”

I wish. But no way.



Erami





Now it’s September…



Aly, with Jo (Turaga ni Koro, Komave)





4Sep: PROBLEM: we will need tools. No carpenter likes to loan his tools (they come back dull, destroyed, or not at all). So I buy my own (non-reimbursed), over a hundred bux worth. I just want to get it done.



5Sep: a host of village folks, Aly, & I work all day til dark. Finally started, foundation done.





And so on: it was a long battle. A&I worked very hard, as did numerous village men & ‘youth’, who some days worked very long hard days, who other days drifted in&out, who others could work not at all, diverted by other Fijian responsibilities (church, ceremonies, harvest, fishing, accommodation of tourists (Komave has a very fine and highly organized tourist program), etc). Even A&I were preventing from working some days, hammering being inconducive to prayer.



I was very pleased with villager participation & cooperation, especially given that their attitude is skeptically ‘wait & see’. Despite our explanations of how flush toilets have destroyed the reef, they are quite happy with them. As the TK of Biasevu eloquently (& politely) related: You white people came and told us to replace our pit toilets with flush toilets; now you tell us to replace our flush toilets with something that seems very much like what we had before.

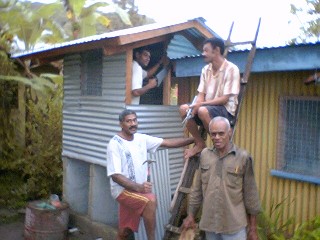

2Nov: DONE (except filling the waterline trench across the road with sand, so that the stony soil will not wear thru the plastic pipe, and the vault doors could use some planing). (Oh, and the old electric line, hanging in tatters from a pole, has yet to be repaired. Someone else’s responsibility.) The whole process, despite truly diligent effort, took like 2.5 months. About 2 days per square foot.







Lessons Learned



·         Duh, everything takes a long time.

·         I’m a very competent carpenter in the US, but it means nothing here. The materials are different, THERE ARE NO POWER TOOLS, I suck at the language (and many of the laborers likewise at English), there is no Ace Hardware or Home Depot within any short distance and I don’t have my pickup to buzz over there even if there was.

·         Even speaking English with the hardware store guys (who were marvelous), it’s like they have a different term for everything. Ask for “lumber” & they have no idea you’re referring to “timber”. Even a 2x4, here, is a “4x2”.

·         Tho’ they do understand the English system of measurement, basicly they’re on metric. Hence, ask for a 20-ft length of pipe, and you’ll get a metric-based thing that’s a couple feet less. My next project, I’ll design it in metric.

·         Ask for a 2x4 in the US and you get a 1.5x3.5. Ask for a 2x4 here, you get a 2x4. OK, ask for a 1x2 here, you get a 1x2, right? No, you get a 5/8x1&9/16. This can be critical.

·         The wood here (Vesi) is VERY DENSE. Extremely difficult to cut/nail/drill/etc. Especially when the night after they delivered it (stacked ATOP the metal roofing), it rained, hard.

·         Corrugated metal likewise is hard to work with.

·         THERE ARE NO POWER TOOLS. So not only is it (very) physically hard work, but every cut comes out quite significantly crooked. Nothing fits tight, a major issue for someone seeking hi-quality.

·         Transport of materials is a significant issue. The hardware stores deliver for free, but when? Will the bus or mini-bus accommodate 20-ft timbers or pipes?

·         Schedule a time and day for work, and no one will be there. Instead, just start working. People come.

·         Fijians in fact know what they are doing very well, there’s one way to do it, and if you try to do it a different way, they are skeptical, and politely offer to do it for you the right way. I learned a lot.

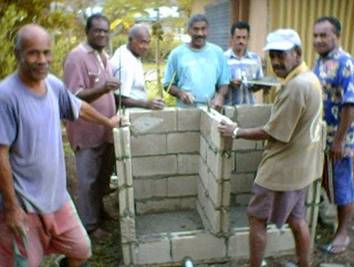

·         On the other hand, they accept a much lower standard of quality than would ever be accepted in the US. The 4-ft-hi block wall for the CT vault, which I left to them to do because surely they know how to build block walls, was 2 inches off, top-to-bottom. Really bad.

·         Kids are everywhere, get into everything, are always in the way, scream randomly, and non-maliciously relocate every item you set down.

·         It rains, torrentially. After that, it’s intensely hot/humid for a while. Then it rains.
